Share Shakespeare Street stormwater rehabilitation on FacebookShare Shakespeare Street stormwater rehabilitation on X (formerly Twitter)Share Shakespeare Street stormwater rehabilitation on LinkedinEmail Shakespeare Street stormwater rehabilitation link

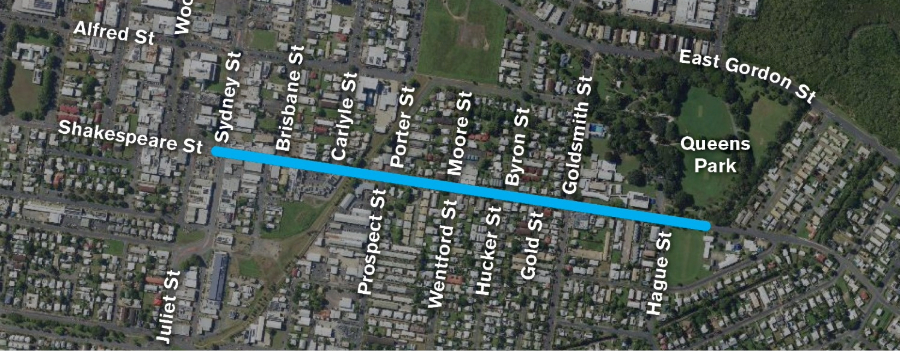

We are completing essential rehabilitation works to 1.1 kilometres of the stormwater line along Shakespeare Street, between Sydney and Hauge streets.
The works will improve the reliability of the network and preserve an important piece of Mackay’s historical infrastructure.
The oval‑shaped stormwater pipe, constructed of dual‑layered brick between 1860 and 1910, shows signs of deterioration. To preserve this important piece of Mackay’s history, prevent further pavement damage and maintain the stormwater service, significant works are required.
Works will include:
Cleaning debris from the line.
Constructing new access chambers to improve accessibility for future maintenance and repairs.
Replacing a section of deteriorated line.
Installing custom pipe lining.
Specialist contractor Interflow will complete the works on behalf of council from late-April, 2026.
Work is expected to be completed by mid-October, 2026, weather permitting. However, the nature of the work means that additional scope may be required, which can only be assessed once the work has commenced.
To minimise impacts on surrounding businesses, schools, road users and nearby facilities, work will take place at night: 6pm to 6am, Monday to Friday.

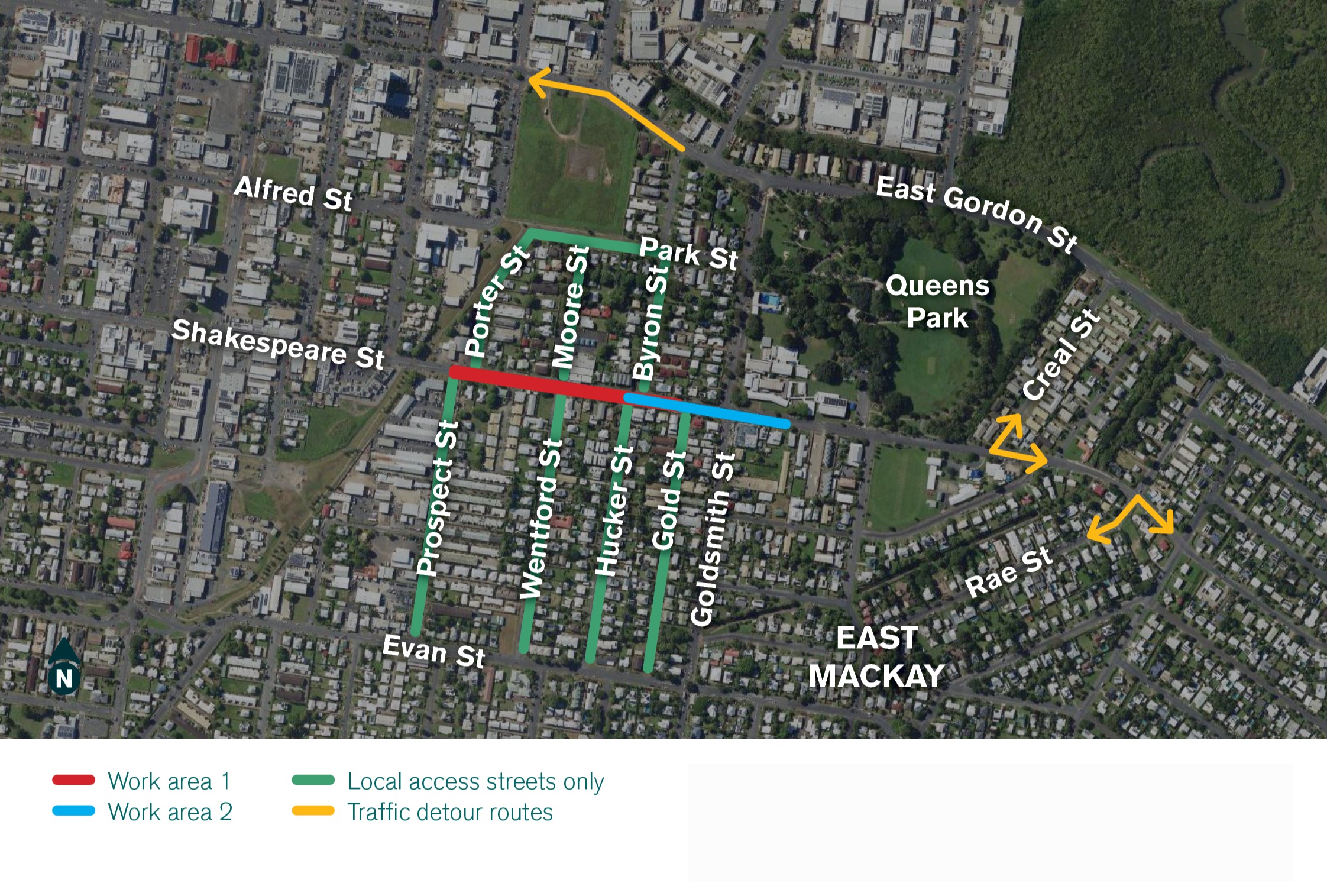

Due to the location of the stormwater line in the middle of the road, short detours will be required. Detours will change frequently as the work location changes.
Upcoming detour / road closure:
More information will be provided soon about upcoming works to construct the new access chambers.
Stay updated on this project by subscribing to its project update emails. Click the Stay Informed button on this page. You will receive an email afterwards asking you to confirm your subscription.
We are completing essential rehabilitation works to 1.1 kilometres of the stormwater line along Shakespeare Street, between Sydney and Hauge streets.
The works will improve the reliability of the network and preserve an important piece of Mackay’s historical infrastructure.
The oval‑shaped stormwater pipe, constructed of dual‑layered brick between 1860 and 1910, shows signs of deterioration. To preserve this important piece of Mackay’s history, prevent further pavement damage and maintain the stormwater service, significant works are required.
Works will include:
Cleaning debris from the line.
Constructing new access chambers to improve accessibility for future maintenance and repairs.
Replacing a section of deteriorated line.
Installing custom pipe lining.
Specialist contractor Interflow will complete the works on behalf of council from late-April, 2026.
Work is expected to be completed by mid-October, 2026, weather permitting. However, the nature of the work means that additional scope may be required, which can only be assessed once the work has commenced.
To minimise impacts on surrounding businesses, schools, road users and nearby facilities, work will take place at night: 6pm to 6am, Monday to Friday.
Due to the location of the stormwater line in the middle of the road, short detours will be required. Detours will change frequently as the work location changes.
Upcoming detour / road closure:
More information will be provided soon about upcoming works to construct the new access chambers.
Stay updated on this project by subscribing to its project update emails. Click the Stay Informed button on this page. You will receive an email afterwards asking you to confirm your subscription.
Share Project update: June 22, 2026 on FacebookShare Project update: June 22, 2026 on X (formerly Twitter)Share Project update: June 22, 2026 on LinkedinEmail Project update: June 22, 2026 link
Stage 2 work underway off-site
Rest assured that while the worksite is currently quiet, work is taking place behind the scenes for Stage 2 of the stormwater line rehabilitation.
The concrete access chambers (pits) are being constructed off-site, allowing for a reduced duration of on-site impacts to residents and motorists. This method also limits the crew's exposure to tidal flows while working in the lines.

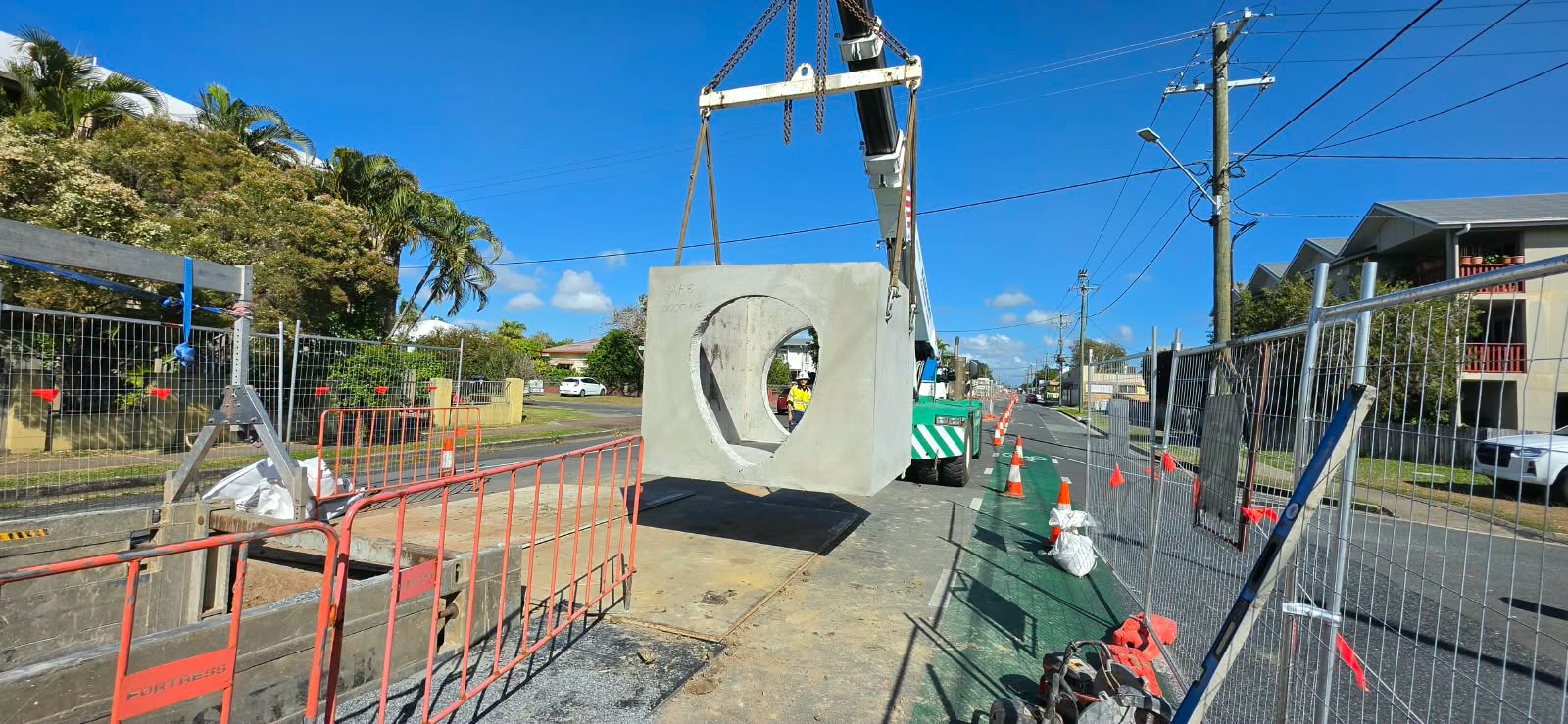

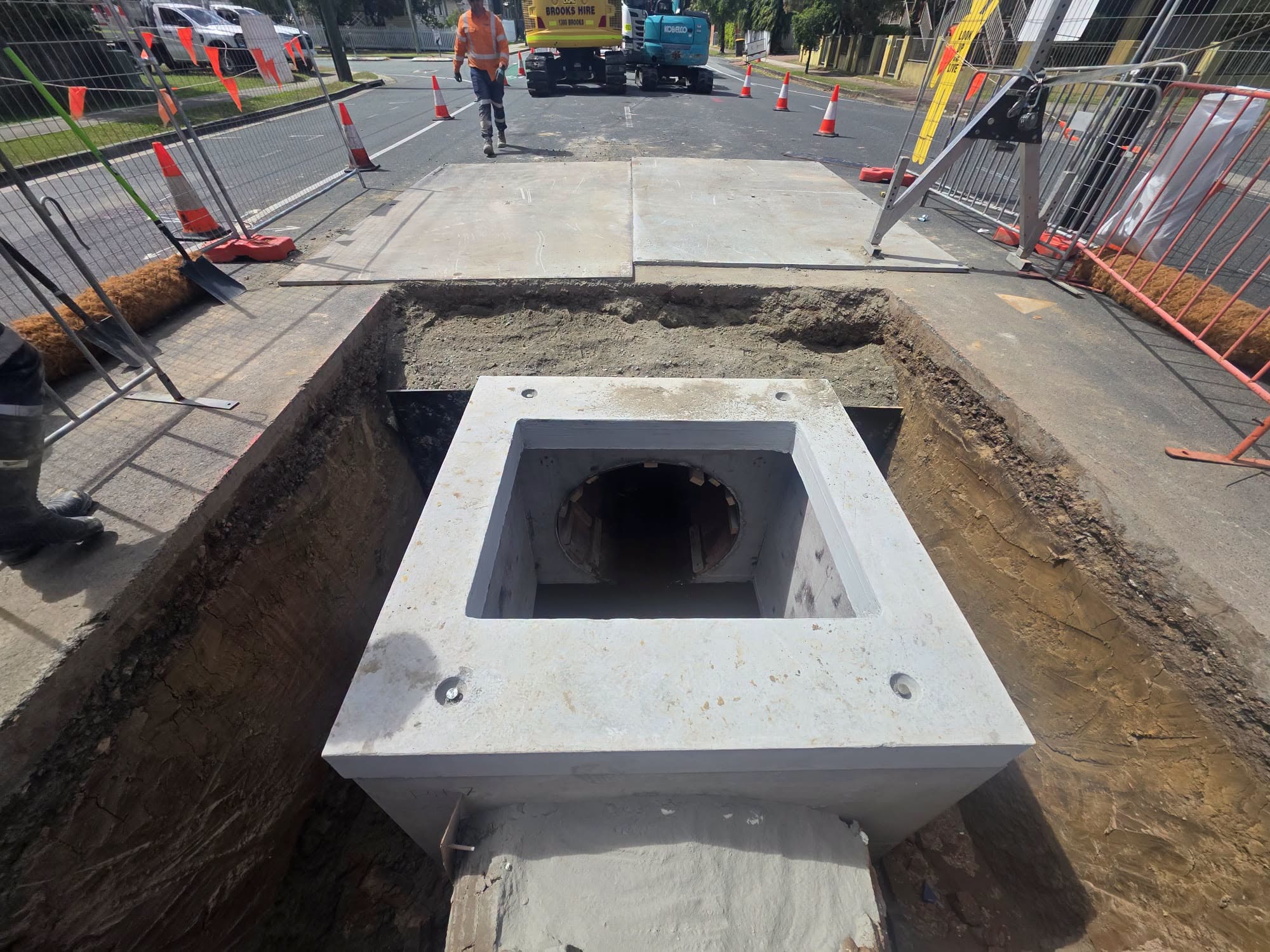

Once the pits are constructed, onsite work will restart from early August to install them.
Stage 2 works also include replacement of approximately 20 metres of the existing pipe which has deteriorated beyond reasonable repair near Hucker and Byron streets.
Stage 2 is expected to be completed in August, with Stage 3 (relining) to start immediately afterward.
Further updates will be provided as the project progresses - stay tuned!
Stage 2 work underway off-site
Rest assured that while the worksite is currently quiet, work is taking place behind the scenes for Stage 2 of the stormwater line rehabilitation.
The concrete access chambers (pits) are being constructed off-site, allowing for a reduced duration of on-site impacts to residents and motorists. This method also limits the crew's exposure to tidal flows while working in the lines.
Once the pits are constructed, onsite work will restart from early August to install them.
Stage 2 works also include replacement of approximately 20 metres of the existing pipe which has deteriorated beyond reasonable repair near Hucker and Byron streets.
Stage 2 is expected to be completed in August, with Stage 3 (relining) to start immediately afterward.
Further updates will be provided as the project progresses - stay tuned!
Share Project update: May 21, 2026 on FacebookShare Project update: May 21, 2026 on X (formerly Twitter)Share Project update: May 21, 2026 on LinkedinEmail Project update: May 21, 2026 link
Stage one of rehabilitation works on 1.1km of the century-old stormwater line through Shakespeare Street has now been completed.

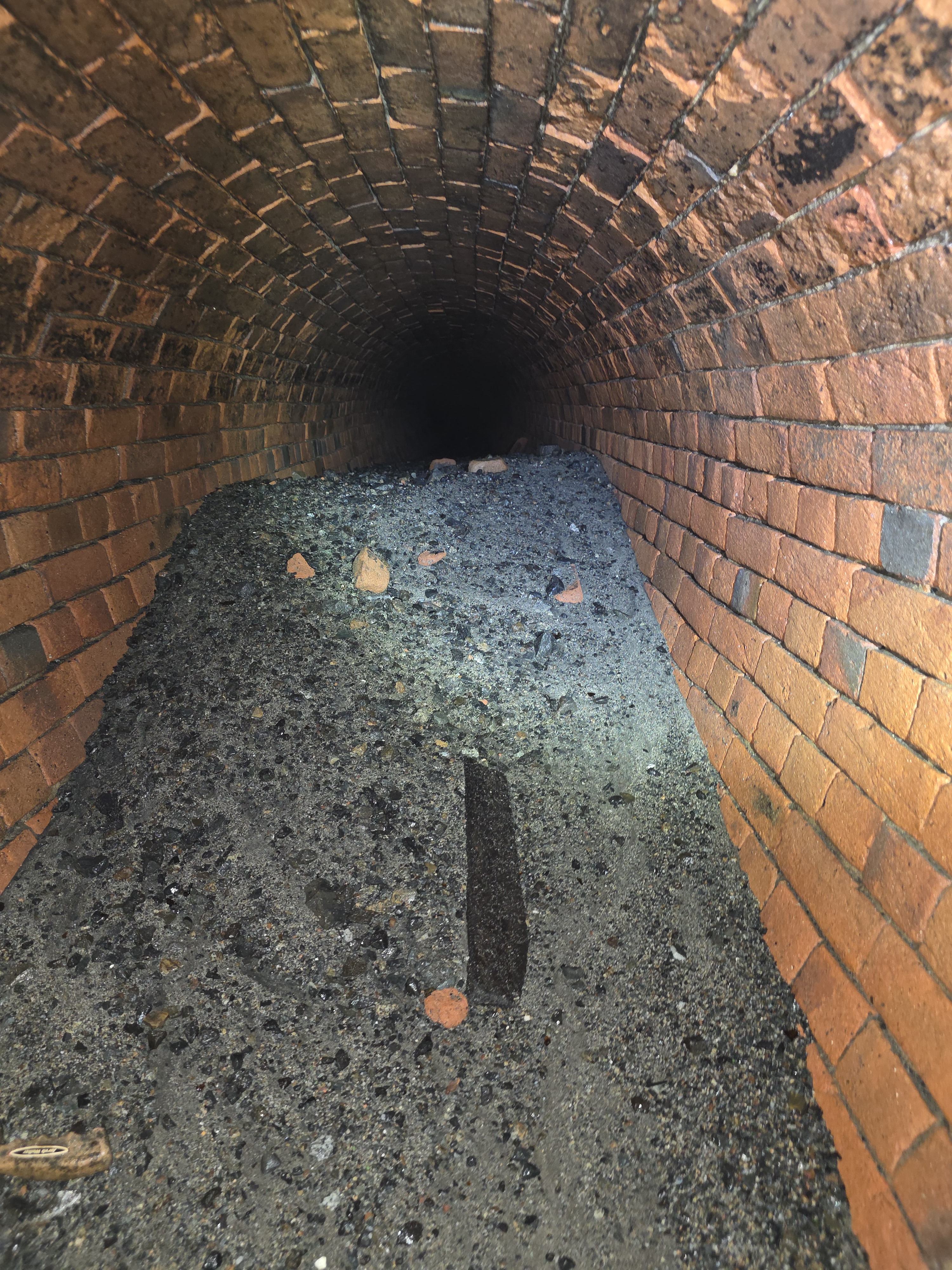

The line has been cleaned and a huge 80 tonnes of debris has been removed!
Most of the drains in South Mackay flow into Shakespeare Street stormwater line. It's also subject to high and low tides which means there has been a lot of water and debris flowing through the line.
The debris is made up of mostly sand, gravel and bits of concrete which have built up over the years.
Redundant services like water mains, sewer mains and gas mains have also been tested and removed by Interflow.
Now that the line is cleaned and a full condition assessment has taken place, materials are being ordered for stage two (pit construction) and stage three (relining) of the works.
More information will be provided soon with confirmed dates for construction of the pits.
Subscribe to project update emails to stay informed.
Stage one of rehabilitation works on 1.1km of the century-old stormwater line through Shakespeare Street has now been completed.
The line has been cleaned and a huge 80 tonnes of debris has been removed!
Most of the drains in South Mackay flow into Shakespeare Street stormwater line. It's also subject to high and low tides which means there has been a lot of water and debris flowing through the line.
The debris is made up of mostly sand, gravel and bits of concrete which have built up over the years.
Redundant services like water mains, sewer mains and gas mains have also been tested and removed by Interflow.
Now that the line is cleaned and a full condition assessment has taken place, materials are being ordered for stage two (pit construction) and stage three (relining) of the works.
More information will be provided soon with confirmed dates for construction of the pits.
Subscribe to project update emails to stay informed.
Share Project update: April 16, 2026 on FacebookShare Project update: April 16, 2026 on X (formerly Twitter)Share Project update: April 16, 2026 on LinkedinEmail Project update: April 16, 2026 link
Due to the ongoing overseas conflict, the project team and contractor have reviewed the delivery methodology and project staging to ensure the works can still be delivered in a timely and cost‑effective manner.
As the existing stormwater line is a non-standard shape, a custom lining is required. This lining cannot be sourced locally, resulting in longer lead times.
To help manage these constraints, the project staging has been revised as follows:
Cleaning of the stormwater lines, originally planned for Stage 2, will now be undertaken first. Completing this work early will allow materials for subsequent stages to be ordered sooner, helping to mitigate supply-chain risks and potential delays.
Construction of the access chambers, originally planned as Stage 1 to allow for easier access for the cleaning process, will now proceed as the second stage of works. The timing for this stage is currently under review and further information on anticipated construction dates will be provided as soon as possible.
Construction on this project will now commence in late April as the cleaning crew are finalising works at other sites within the region.
We appreciate your patience and understanding while continue work through this.
Due to the ongoing overseas conflict, the project team and contractor have reviewed the delivery methodology and project staging to ensure the works can still be delivered in a timely and cost‑effective manner.
As the existing stormwater line is a non-standard shape, a custom lining is required. This lining cannot be sourced locally, resulting in longer lead times.
To help manage these constraints, the project staging has been revised as follows:
Cleaning of the stormwater lines, originally planned for Stage 2, will now be undertaken first. Completing this work early will allow materials for subsequent stages to be ordered sooner, helping to mitigate supply-chain risks and potential delays.
Construction of the access chambers, originally planned as Stage 1 to allow for easier access for the cleaning process, will now proceed as the second stage of works. The timing for this stage is currently under review and further information on anticipated construction dates will be provided as soon as possible.
Construction on this project will now commence in late April as the cleaning crew are finalising works at other sites within the region.
We appreciate your patience and understanding while continue work through this.
Page last updated: 22 Jun 2026, 08:38 AM
Custom
Area: Mackay City Centre
Status: Current construction
Published: March 19, 2026
Follow Project
Stay informed
Subscribe for project updates
Custom
Timeline
Stage 1 - Cleaning and condition assessment
Shakespeare Street stormwater rehabilitation is currently at this stage
Cleaning will be completed from late April. Approximately 80 tonnes of material will be removed from the stormwater line.
Stage 2 - Installation of new access chambers (pits) and 20 metres of new line
this is an upcoming stage for Shakespeare Street stormwater rehabilitation
Up to 12 new pits will be installed.
Twenty metres of the existing pipe that has deteriorated beyond reasonable repair (near Hucker and Byron streets) will be replaced.
Stage 3 - Relining
this is an upcoming stage for Shakespeare Street stormwater rehabilitation
The stormwater line will be relined with custom cure-in-place lining between late August and mid-October.

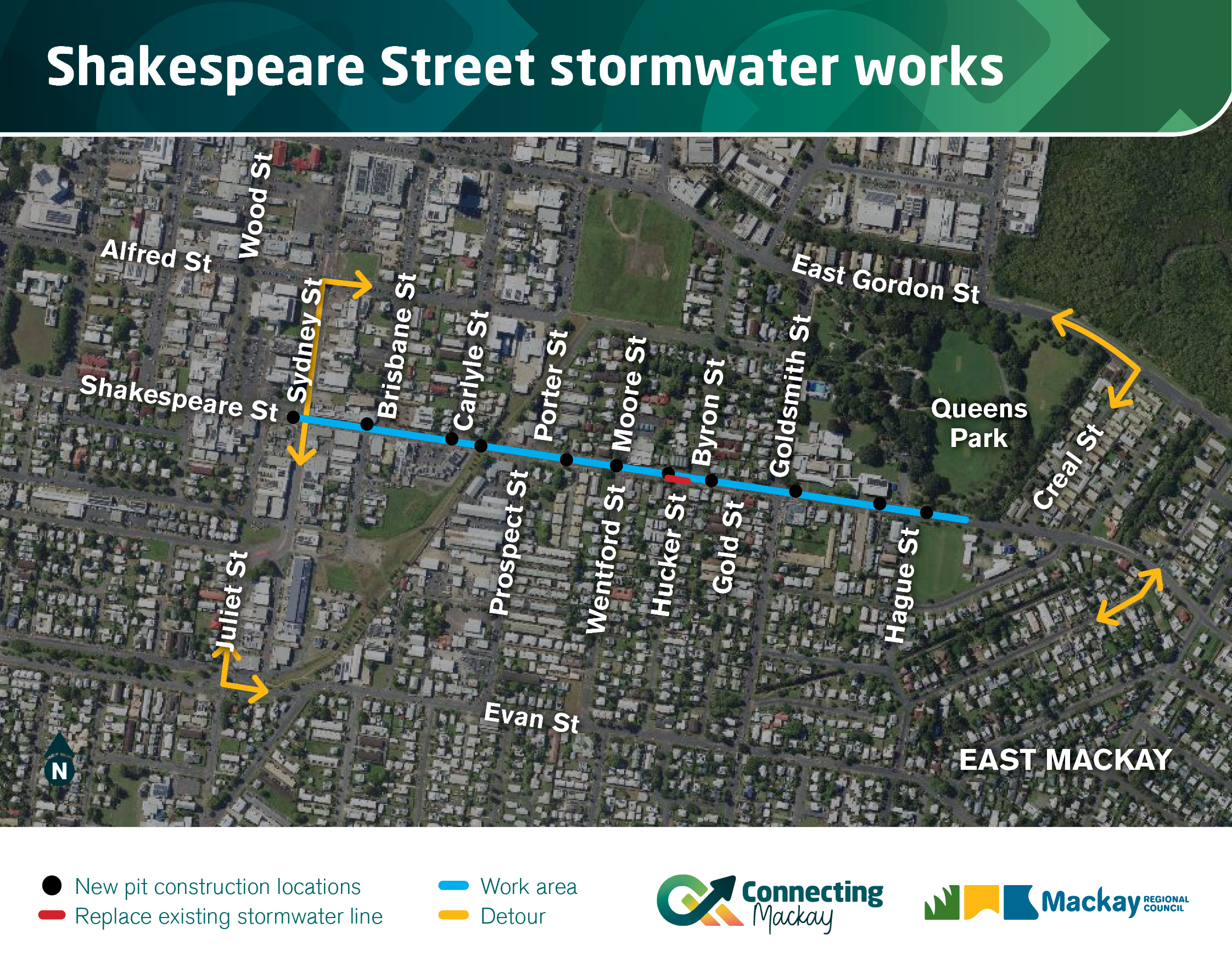

Work will take place from the existing and new pits between Sydney and Hague streets. See map of locations here.
Construction complete
this is an upcoming stage for Shakespeare Street stormwater rehabilitation
Construction is expected to be completed by late October, 2026, weather permitting.
